A NSW Government website

Hunter Transmission Project

Refining the Hunter Transmission Project

Our end-of-year community update 'Refining the HTP' highlights the latest project developments and details how the HTP will be assessed during 2025.

Read now

The Hunter Transmission Project is critical for the transition

As coal-fired power stations close, the HTP is critical for energy security in NSW.

It involves building a new above-ground 500 kilovolt (kV) transmission line of around 100 kilometres between Bayswater in the Upper Hunter and Olney in the Lower Hunter to connect the State’s existing 500 kV transmission lines. This will help create a 500 kV ring of transmission infrastructure that will provide the backbone of the State’s new electricity grid for generations to come.

Importantly, it will unlock the electricity supply from the Central-West Orana and New England REZs and allow it to be imported to the new electricity grid via Bayswater. From here it will be delivered to consumers across NSW.

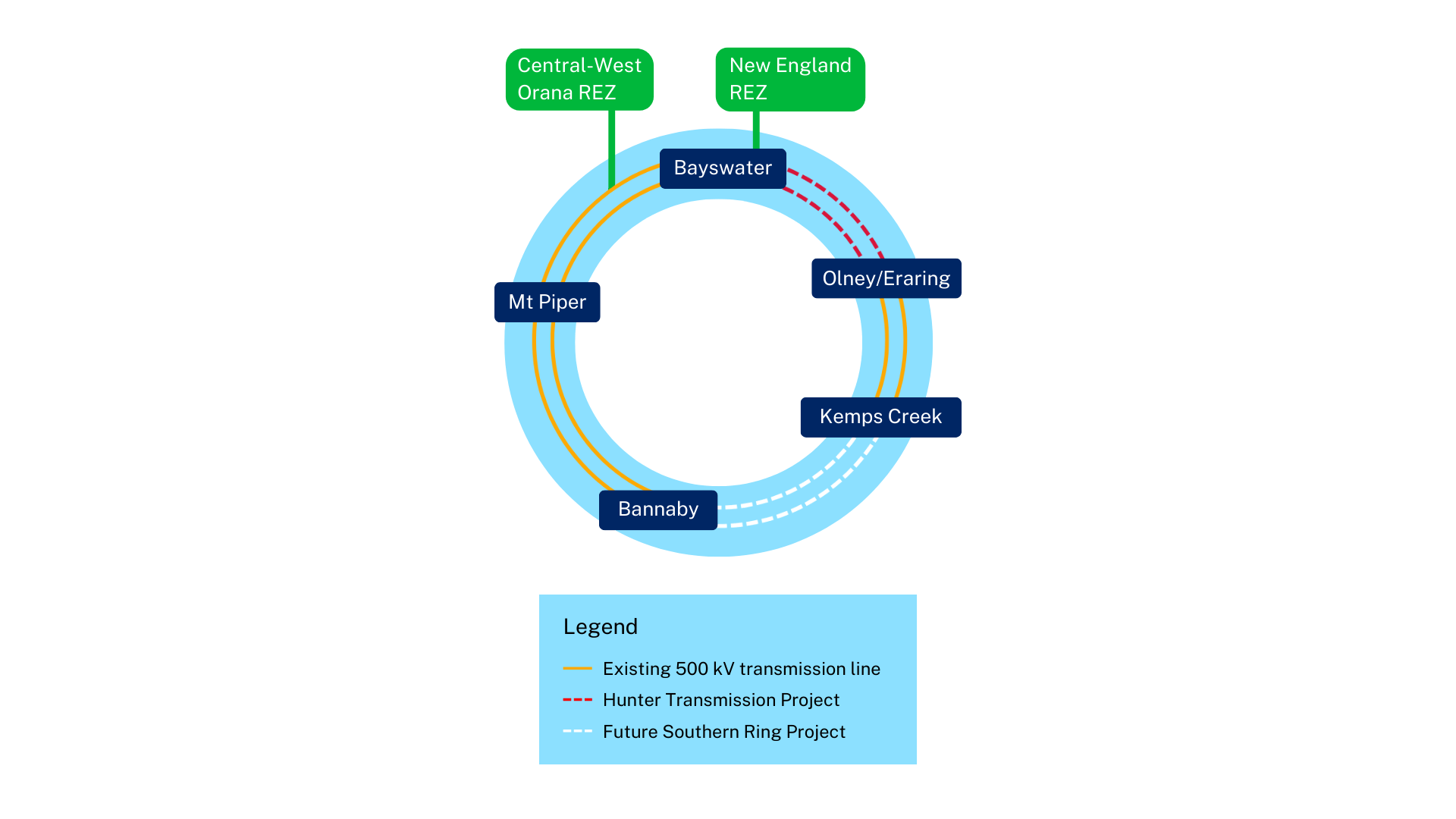

HTP power circle

Refining the HTP

We have released our end-of-year community update, ‘Refining the HTP’, marking another chapter in this once-in-a-generation transmission infrastructure.

Over the past year, we have made significant progress in scoping and shaping the Hunter Transmission Project, with input from our community.

Read about the latest developments in the project, including:

  • The refined transmission corridor based on feedback, consultation and technical studies.
  • We are working with fewer than 25 private landowners to acquire easements to host the transmission infrastructure (down from 78 potentially affected landowners in the preliminary corridor presented a year ago).
  • Technical studies are underway on required assessment areas including biodiversity (plants and animals), Aboriginal cultural heritage, visual and social impacts, roads and traffic, and more.

Read Refining the HTP

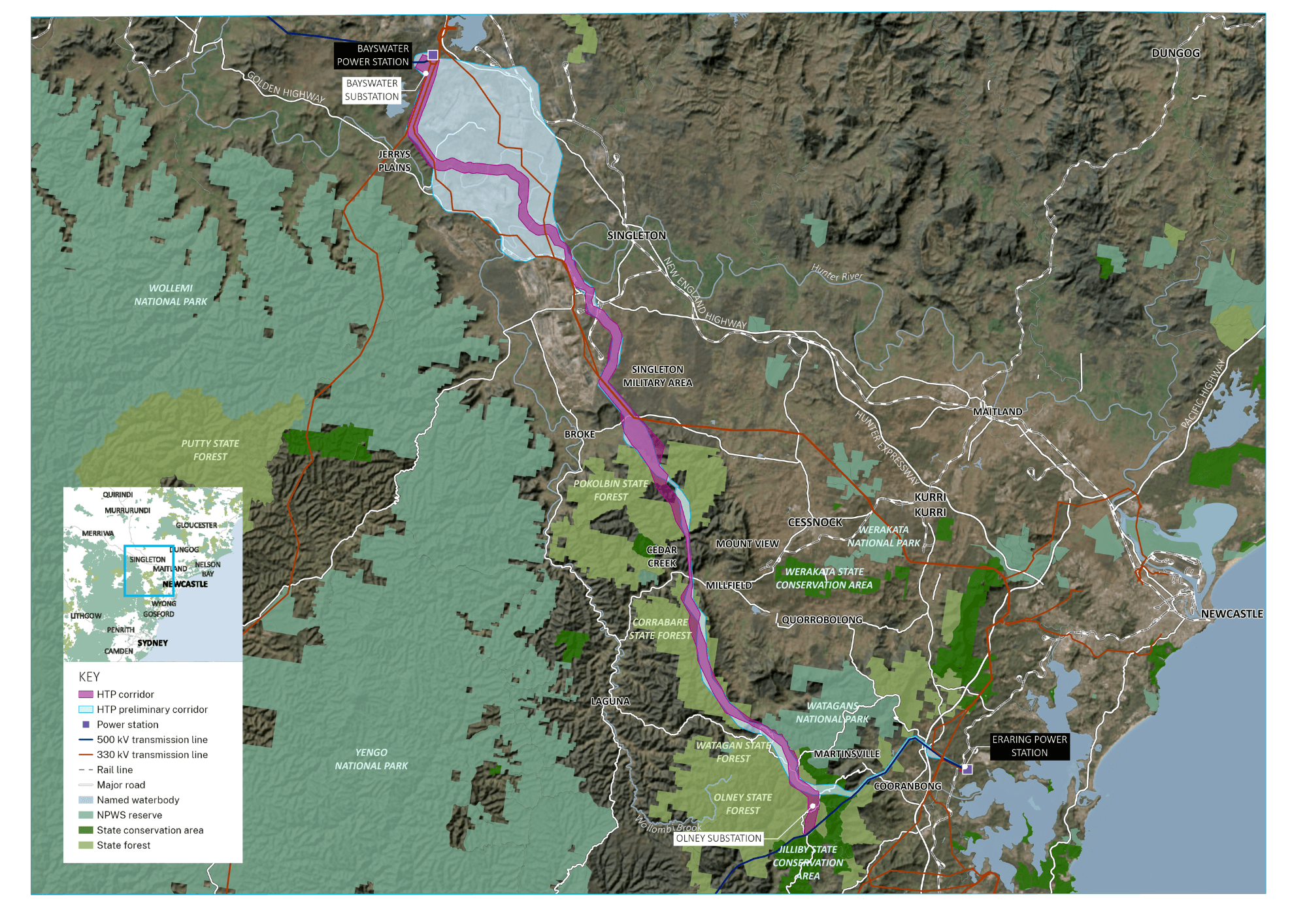

Download a refined corridor map

Next steps

The environmental impact statement (EIS) is anticipated to be lodged in mid-2025. It will then be placed on public exhibition and the community will be asked to provide formal feedback.


Latest news

Design and construction contractors shortlisted

To support the delivery of the Hunter Transmission Project, EnergyCo has commenced a procurement process for design and construction contractors.

Following a competitive expression of interest process that was launched earlier this year, EnergyCo has shortlisted a number of contractors to participate in the tender processes for two work packages. The two work packages are:

  • the transmission line package, and
  • the substations/switching stations package.

A total of seven contractors have been shortlisted to be invited to participate in the tender phase. The shortlisted contractors across the two packages are:

Transmission line package

  • Acciona Genus Joint Venture
  • Downer Utilities Australia Pty Ltd
  • Gamuda Seymour Whyte Joint Venture
  • UGL Engineering CPB Contractors Joint Venture

Substation package

  • Acciona Genus Joint Venture
  • Consolidated Power Projects Australia Pty Ltd
  • UGL Engineering Pty Ltd

We are now working to prepare request for tender packages that will be shared with shortlisted contractors in early 2025. It is expected that the contract will be awarded in 2026.

EnergyCo is encouraging contractors to partner with local businesses to facilitate the delivery of the HTP.

EnergyCo has facilitated the development of a local supplier database that will be included in the tender documents for provision to shortlisted contractors.

Under the First Nations Guidelines, tenderers will also be required to provide Aboriginal Participation Plans demonstrating how they will use local Aboriginal businesses, skills and workforce.

Businesses can still register their interest in participating in the HTP by registering on the ICN gateway. This directory will be provided to the tenderers.

Environmental impact statement (EIS) to be lodged in 2025

The HTP is currently in the planning phase and EnergyCo is in the process of preparing a detailed environmental impact statement (EIS) in line with the State significant infrastructure guidelines.

We now anticipate lodging the EIS in mid-2025.

Ongoing feedback from landowners and community groups is an important consideration for this revised timeline. In particular, the project team is working with a small number of landowners to further improve the corridor where it crosses private land in HTP North and Central.

An EIS provides information on the economic, environmental, and social impacts of a project. This helps the community, government agencies and the approval authority make informed submissions and decisions about the project.

The HTP is a critical State significant project and delivering it in a region as diverse as the Hunter is technically complex. Impacts are being carefully considered and assessed as part of the EIS process.

We’ll continue to provide regular updates on the project and planning process.

Please make sure you sign up for our project newsletter if you want to and haven’t already.

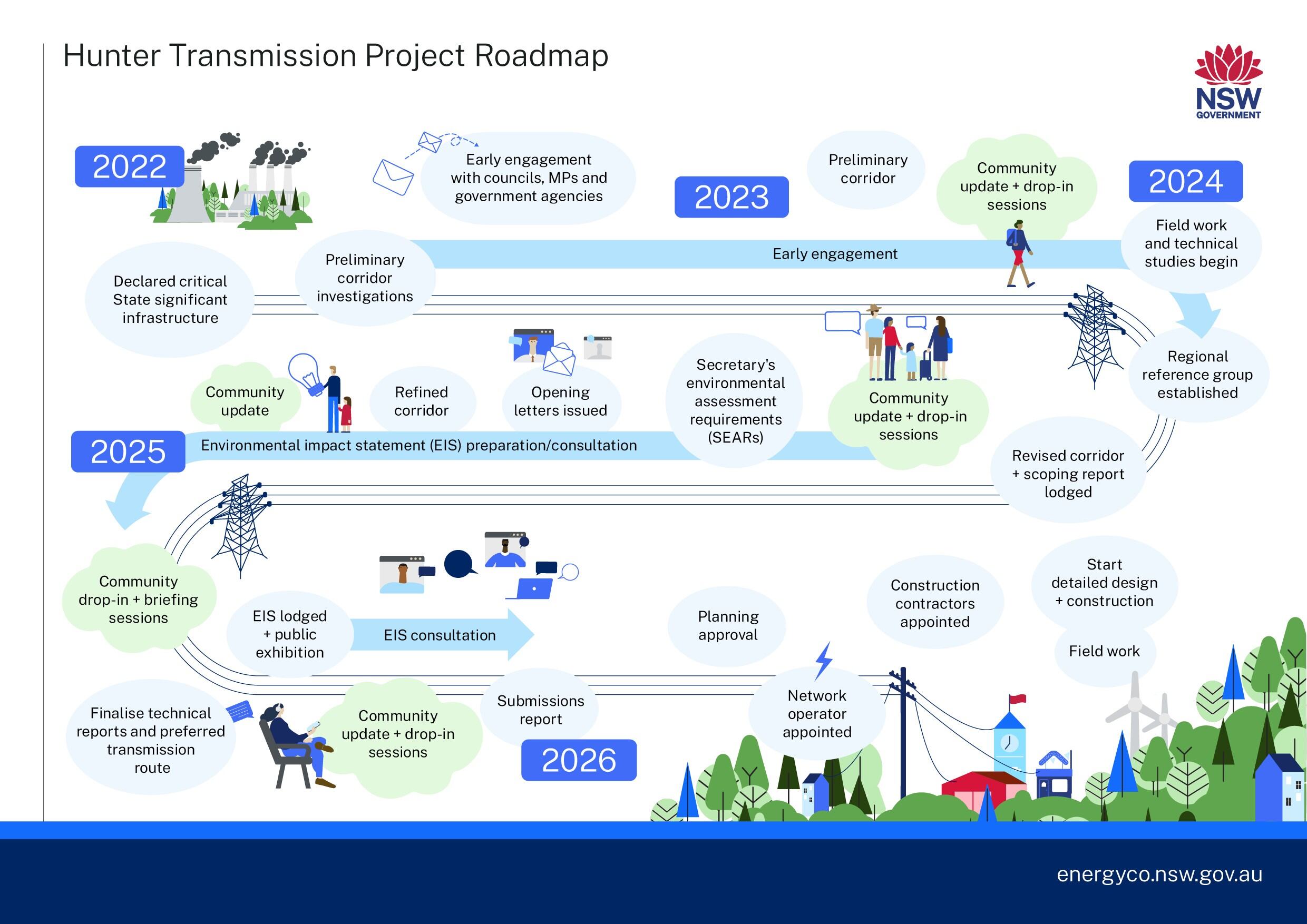

Hunter Transmission roadmap infographic December 2024

Strategic importance

Both the NSW Government and Australian Government recognise the strategic importance of the HTP.

At the State level:

  • the Minister for Climate Change, Energy, the Environment and Heritage has classified it as a Priority Transmission Infrastructure Project
  • the Minister for Planning and Public Spaces has declared it critical State significant infrastructure.

That means the HTP needs the approval of both ministers following extensive public consultation before it can go ahead.

It also requires the approval of the Australian Government Minister for the Environment and Water.

Snowy Mountains wind turbine

NSW is transitioning to a cleaner future

Our ageing coal-fired power stations are reaching the end of their life. Some are closing faster than expected, with most due to shut in the next 10 years.

At the same time, our demand for electricity is increasing as our population grows and we electrify our vehicles, homes, businesses and industry.

The NSW Government has a plan to ensure this demand is supplied by renewable energy and to provide cleaner, more affordable and reliable electricity to consumers.

EnergyCo is leading the implementation of this plan, which involves:

  • generating electricity (wind and solar) in Renewable Energy Zones (REZs) across NSW
  • improving the reliability of the grid with new storage capacity (batteries and pumped hydro)
  • building new transmission infrastructure such as the Hunter Transmission Project to deliver clean energy to consumers.

Find out more about the HTP

Community members were invited to have their say on the HTP preliminary corridor in late 2023

A list of questions and answers about the HTP

More resources about the HTP

How EnergyCo is working with the HTP community

About the HTP regional reference group

Treading lightly to minimise environmental impacts

Early investigations and feedback helped us to avoid important environmental areas.

This includes:

  • avoiding the Watagans National Park near Cooranbong
  • minimising the clearing of scarce valley floor vegetation, such as the critically endangered Central Hunter Valley eucalyptus forest woodland and Warkworth Sands Woodland
  • minimising the removal of critical habitat for key threatened species, such as the regent honeyeater and swift parrot
  • protecting scenic landscapes and culturally sensitive areas.

We're continuing to work with all stakeholders including the community, National Parks and Wildlife Service, and Forestry Corporation to avoid and minimise potential impacts on plants and animals, and Aboriginal cultural heritage.

Alternative corridor options

In a region as diverse as the Hunter it is difficult to find a suitable route between Bayswater and Eraring.

To guide this search, we developed strategic objectives for the project:

  • maximise the use of power station and mine-owned land, suitable public land and existing transmission easements
  • minimise significant land use conflicts and impacts on people and the environment
  • minimise hazards and risks
  • build community support
  • deliver the project on time at a reasonable cost to consumers.

We then carried out extensive investigations to identify where the HTP could be located. This included detailed electricity system planning, strategic land use planning, engineering and environmental studies (bushfire, biodiversity, heritage and visual) and consultation with key stakeholders such as local councils.

Initially, we divided the Hunter into 3 broad strategic corridors (northern, central and southern) and examined the suitability of each corridor. We rejected the northern and central corridors as they would both result in significant land use conflicts and impacts to people in the urban areas between Singleton and Newcastle as well as the Pokolbin wine/tourist area.

Using the northern corridor would also involve building a much longer and more expensive transmission line. This led us to examine multiple options in the southern corridor.

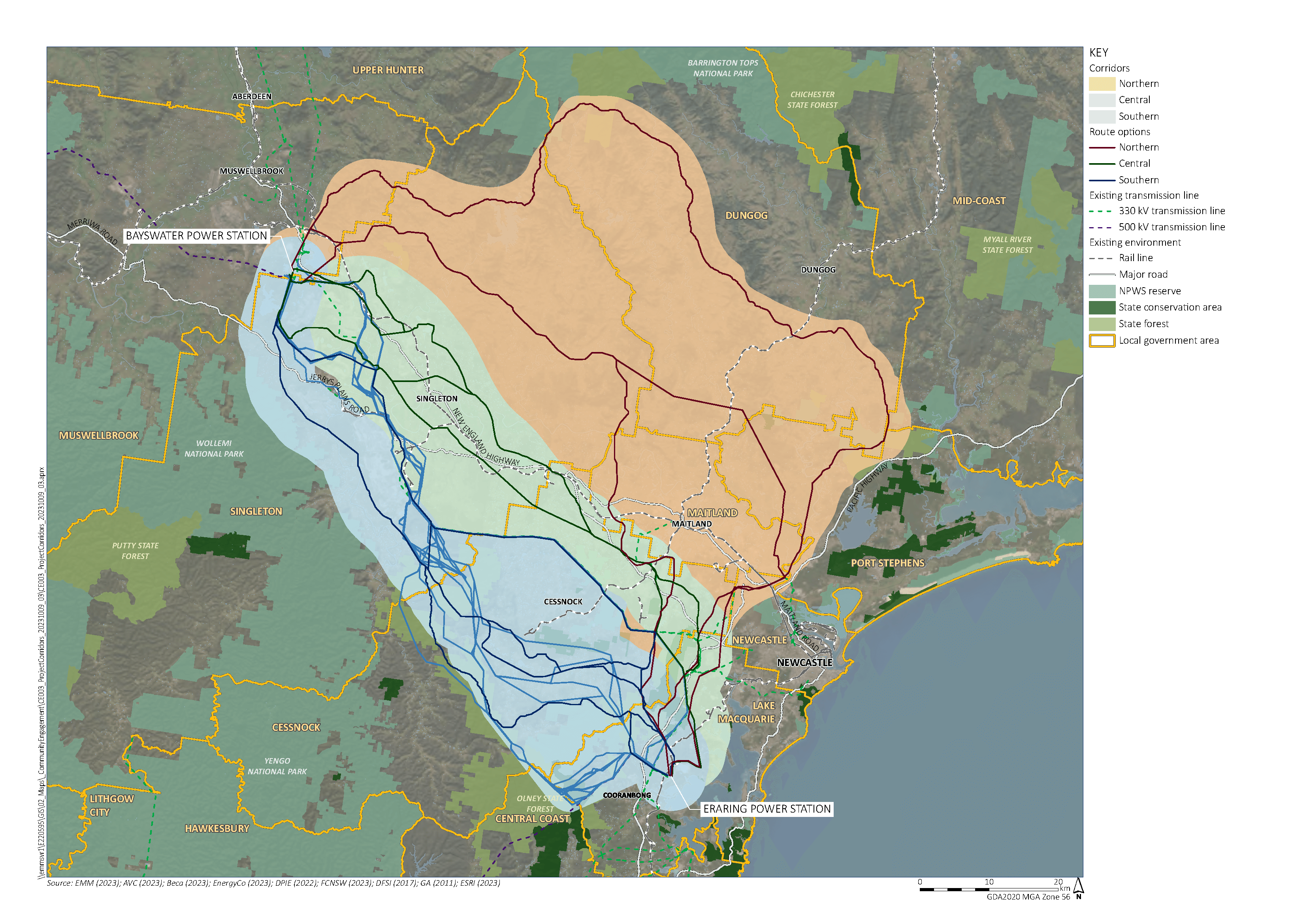

Hunter Transmission Project - alternative route options



Map shows initial investigations to find a suitable corridor for the HTP. Please see the revised HTP corridor for the most up-to-date version.



Using the strategic objectives, we assessed and rejected a number of alternative options for the HTP preliminary corridor.

The existing 330 kV transmission easement between Bayswater and Richmond Vale

This option would be more expensive because the existing lines would need to be taken down and rebuilt to create space for the HTP. It would also take longer, ruling out any likelihood of delivering the HTP by early 2028. This is because the existing lines are essential for supplying electricity to Newcastle, making it difficult to secure the outages needed to construct the new transmission line. Finally, it would increase energy security risks in NSW by concentrating all electricity supply between Bayswater and Newcastle in a single easement.

Next to the existing 330 kV transmission easement

This option would cause significant land use conflicts in the Pokolbin wine/tourist area. It would also cause extensive clearing of endangered valley floor vegetation. This includes the Warkworth Sands Woodland and Central Hunter Valley Eucalyptus Forest and Woodland in areas such as the Singleton Military Area, Werakata State Conservation Area (SCA) and Werakata National Park.

The bushland to the south of the Pokolbin wine/tourist area

This option would result in even greater clearing of endangered valley floor vegetation in the Werakata SCA and Werakata National Park. This vegetation provides critical habitat for several threatened species such as the Swift Parrot and Regent Honeyeater. This option would also cause significant landscape-wide visual impacts in the rural-residential areas around Ellalong and Quorrobolong.

The valley further south of the Pokolbin wine/tourist area

This option would result in significant land use conflicts with the growing residential areas around Millfield and Mount View. It would also cause significant landscape wide visual impacts in the rural-residential areas around Ellalong and Quorrobolong.

Video gallery

Contact us

If you have any questions about the Hunter Transmission Project or would like to provide feedback, please contact us.

Email: [email protected]

Tel: 1800 645 972 (9am to 5pm, Monday to Friday)

You can also register for email updates here
